Our Video Queue Looked Full And Approved For Weeks, And Every Post Was Blocked On Its Own Day

Our Video Queue Looked Full And Approved For Weeks, And Every Post Was Blocked On Its Own Day

Key takeaways

Part of what we do as a GHL consultant Bay Area businesses hire is run their posting. We build the videos ahead of time, line them up in a queue with a date and time for each, and every one gets approved before it can go anywhere. Then a job checks the queue every fifteen minutes and posts whatever is due and approved.

That setup has a quiet strength and a quiet weakness. The strength is you can build weeks ahead. The weakness is also that you built weeks ahead.

A page that kept missing days

On September 21 we got asked a simple question. Why does this community page keep skipping days?

So we opened its queue. It looked great. Seven videos lined up from September 23 through October 8. Every one marked approved. Every one had its approval on record. If you'd asked "is this page covered for the next two weeks," the honest answer from the queue was yes.

It wasn't. Every single one of those seven would have been blocked on the day it was meant to post.

A new rule met old work

Here's what changed underneath them. Around September 15 we added a visual quality check to the posting job. Every video now has to carry a plan that shows the pictures change often enough and land on the words they go with. For short vertical videos, no single shot holds longer than three seconds. No plan, no post.

It's a good rule. It exists so the picture keeps up with what's being said, instead of sitting on one frame while the words move on.

But these seven were built on September 3 and 4. Nearly two weeks before the rule existed. None of them had a plan, because nothing asked for one when they were made. And a few of them held shots for three and a half to four seconds, so even with a plan written up they'd have failed.

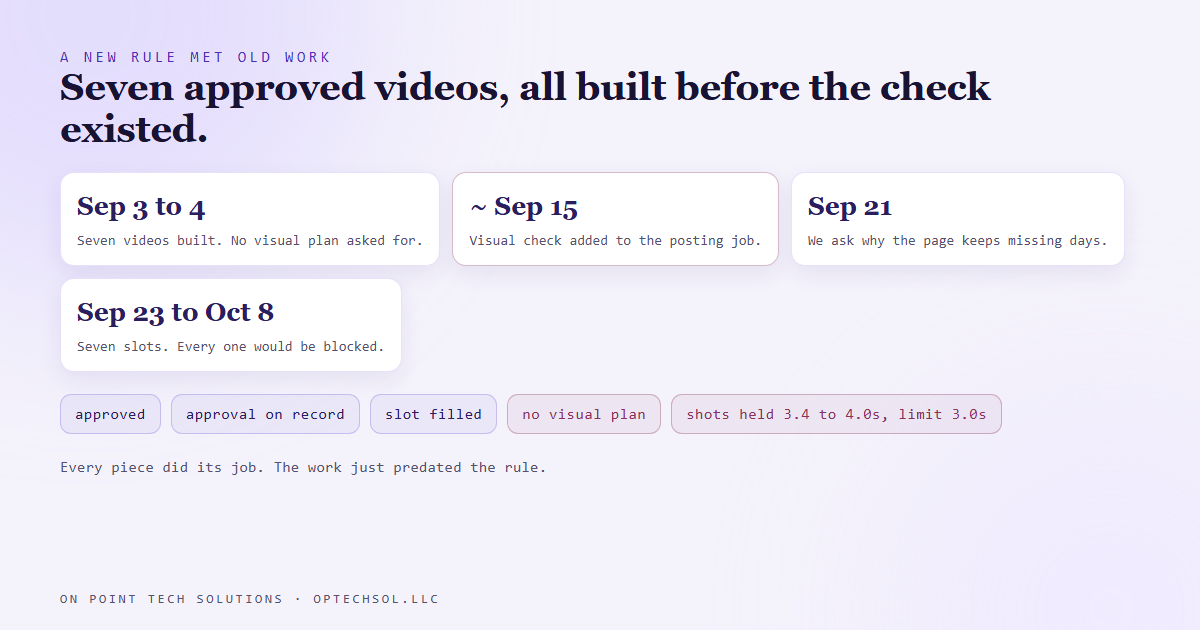

Timeline showing seven videos built on September 3 and 4, the visual quality check added to the posting job around September 15, and the seven posting dates from September 23 to October 8, all of them after the new check

Why nobody saw it coming

This is the part worth the post. Every piece was doing its job.

The check only looks at posts scheduled for today. That's by design. It runs right before posting, so it checks what's about to post. It never looks at tomorrow or next week.

The posting log read healthy. Nothing waiting on approval, a handful still queued. That's exactly what a good day looks like.

And an item only flipped to blocked at the minute it was supposed to go out. Not a day ahead. Not an hour ahead. At the slot. So the first sign of trouble was always a missed post, one day at a time, which just looked like a page that posts irregularly.

We'd seen a cousin of this on September 15. Our nightly build logged a slot as verified and clean, and then a step after the log ran the same check and blocked it. The log was honest about what it knew. It just didn't know about the step after it.

There was one more trap. Once a blocked item's date passed, nothing ever looked at it again. The check only examines today. So a blocked post doesn't unblock itself when you fix it. It has to be fixed and moved to a new date.

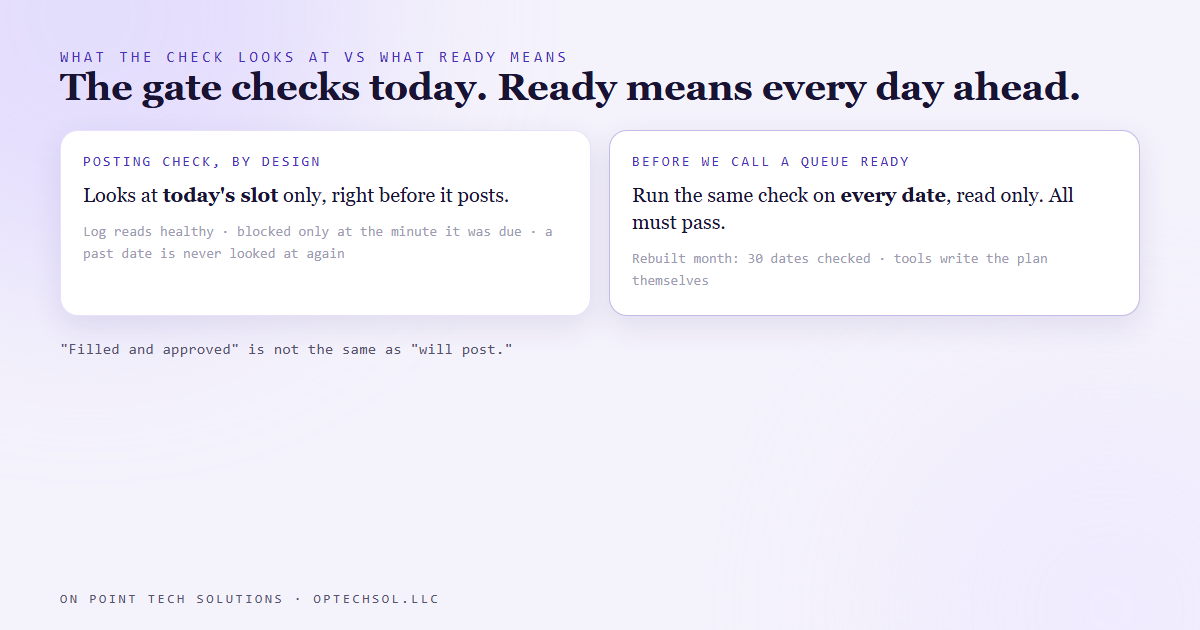

Diagram contrasting what the posting check looks at, only today's slot, with what ready actually requires, every date on the schedule checked ahead of time

What we changed

Now, before we call any queue ready, we run the check across every date on it, without letting it block anything, and every date has to pass. When we rebuilt this page's month, we did exactly that for thirty dates.

We also build these videos with tools that write the plan themselves. The plan can't be the step somebody forgets if nobody has to remember it. And anything made before the rule went in is treated as suspect in every lane until it passes.

The lesson we are keeping

"Filled and approved" is not the same as "will post." A queue can look full for weeks and still be empty in the way that matters.

And when you add a new rule, you have to run it against the old work too. A rule that only checks new things lets the old things fail one at a time, on their own day, where nobody's looking.

What this means when you hire a GHL consultant in the Bay Area

If someone posts for you, or you schedule posts yourself, you probably have a queue somewhere. A calendar in your CRM's social planner. A scheduling app. A spreadsheet your assistant works from.

A full calendar feels like coverage. It isn't, until you know each post can actually go out.

Three things worth doing this week:

  1. Open your scheduled posts for the next two weeks and check each one still has its image or video attached and still connects to the right account.
  2. If you changed a rule recently, a new brand color, a new link, a new approval step, go back through everything already scheduled and check it against the new rule.
  3. Look at last week's calendar next to what actually posted. If there's a gap, find out why before it repeats.

A good GHL consultant Bay Area owners can rely on should be able to tell you, for every day on the calendar, that the post will actually go. Not just that it's scheduled.
